page banner saying Draining the Rain which denotes this is an Improving Urban Waters project
project statys delivery

Project Overview

We are upgrading the waste water network in the Raploch area of Stirling to help manage heavy rainfall, protect the community from flooding and improve the water environment.

The work is part of our £500m Improving Urban Waters programme.

Two projects, totalling £6.2m, at Woodside Road and Laurencroft Road, are expected to be completed by December 2026.

At a glance

  • To prevent sewer debris entering the Firth of Forth
  • £6.2million total investment
  • Delivered by Caledonia Water Alliance
  • Work began in October 2025

Tell us how we’re doing!

We’ve been investing in improving your water and wastewater services across the country, and we’re keen to hear your views and feedback on these works.

Scottish Water has appointed Blue Marble, an independent Market Research Company, to undertake this research on our behalf, exploring what customers think about the projects, and how it impacted them.

To complete the survey, click here

The survey should take no more than 10 minutes, and will remain open until 6 July.

Thank you in advance for taking part in this important research. Your input is very much appreciated, and your feedback will help to shape future projects, not just in your area, but all across Scotland.

Please be assured that all the answers you give will be anonymised before being shared with Scottish Water. We will be unaware who has taken part. The research will be conducted in accordance with the Market Research Society Code of Conduct.

If you have any questions about the research, please email customer.experience@scottishwater.co.uk

Please see the Blue Marble Privacy Notice for further information about how they use personal information. A copy of Scottish Water’s Privacy Notices can be viewed here.
IUW Stirling

Raploch - Stirling

The projects in the Raploch area will help to reduce the chance of sewer related debris from entering the River Forth

What We Are Doing

We are replacing existing storm overflows and upsizing the associated sewer pipework and manhole chambers at both Woodside Road and Laurencecroft Road in Stirling.

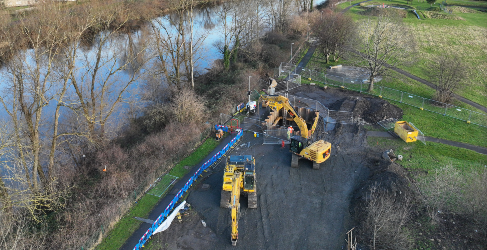

  • Work at Woodside Road began on Monday 20 October 2025, with an expected completion by autumn 2026. A section of footpath at Woodside Road will be closed during the works with a signed diversion in place.

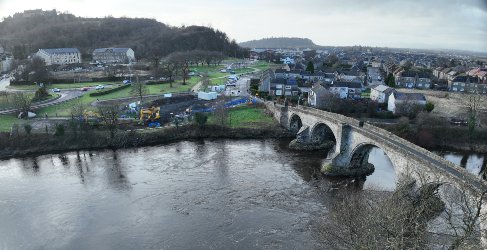

Work at Laurencecroft Road began in January 2026 and is expected to be completed within a year. A section of the cycle path route is closed with a signed diversion in place. Our site compound has been set up in between the two streets at Ochil Crescent for the duration of the works.

IUW Stirling

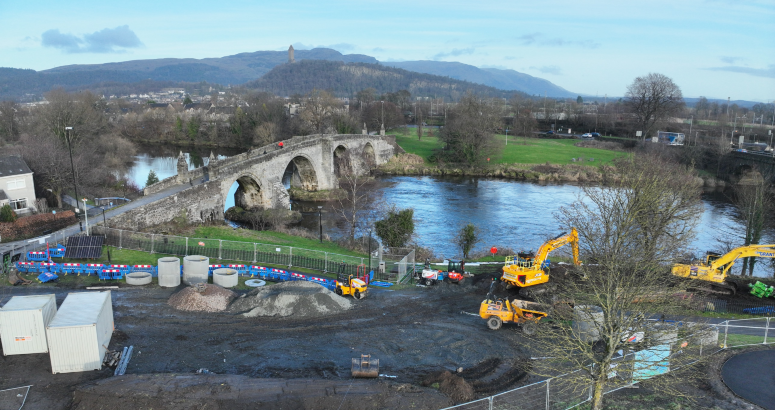

The Laurencecroft Road site is next to Stirling Old Bridge

IUW Stirling

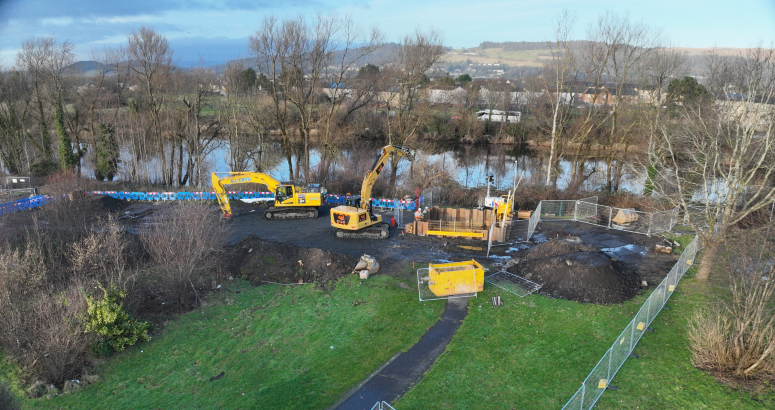

Work began on Woodside Road in October 2025

Why We Are Doing It

Working closely with the Scottish Environment Protection Agency (SEPA) Scottish Water identified priority storm overflows for improvement or replacement.

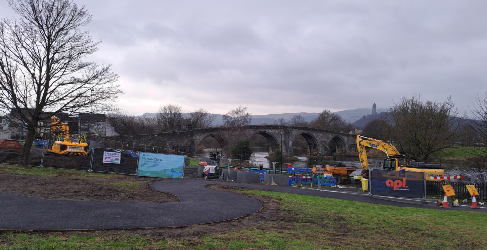

Under the banner ‘Draining the Rain, Enhancing the Environment’ the Improving Urban Waters investment will help reduce spills and prevent sewage related debris such as wet wipes from entering the environment during periods of rainfall.

IUW Stirling

IUW Stirling

Latest Update - January 2026

Our teams started on site at Woodside Road on Monday 20th October 2025.

We started on site at Laurencecroft Road in January 2026.



IUW Stirling

Woodside Road

The new storm overflow chamber is taking shape
